Difference Between Liquidated and Unliquidated Damages

Difference Between Liquidated and Unliquidated Damages

In the realm of civil law, particularly in contract and tort, damages serve as a monetary remedy awarded to an injured party to compensate for loss or injury caused by another’s act or omission. The law distinguishes between liquidated and unliquidated damages, depending on whether the amount of compensation is predetermined or subject to judicial assessment. This distinction is of great importance in understanding remedies available for breaches of duty or contract, as it affects the nature of the claim, the role of the court, and the rights of the parties involved.

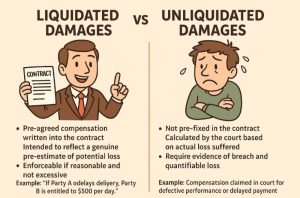

Meaning of Liquidated Damages

Liquidated damages refer to a sum of money that is pre-estimated and agreed upon by the parties to a contract at the time of its formation, as the amount payable in the event of a breach. The purpose is to provide certainty and avoid the need for judicial determination of damages later. Such damages are usually included as a clause in the contract itself, representing a genuine pre-estimate of likely loss rather than a penalty for non-performance.
For example, in a construction contract, the parties may stipulate that for every day of delay beyond the agreed completion date, the contractor shall pay a fixed sum as liquidated damages. This allows both parties to foresee the financial consequences of a breach and manage their contractual risks effectively.
To be enforceable, liquidated damages must not be excessive or punitive in nature. If the stipulated amount is found to be a penalty rather than a genuine pre-estimate of loss, courts may refuse to enforce it. This principle was famously established in Dunlop Pneumatic Tyre Co. Ltd. v New Garage & Motor Co. Ltd. (1915), where Lord Dunedin provided criteria for distinguishing between a penalty and liquidated damages.

Meaning of Unliquidated Damages

Unliquidated damages are not predetermined by the parties but are assessed and awarded by the court based on the actual loss or injury suffered. They typically arise in cases of tortious liability, such as negligence, nuisance, or defamation, and also in contractual breaches where no specific sum has been agreed upon in advance. The amount of compensation depends on evidence presented by the claimant and the discretion of the court.
Unliquidated damages aim to restore the injured party to the position they would have occupied had the wrong not occurred. The damages may include pecuniary losses (such as medical expenses or repair costs) and non-pecuniary losses (such as pain, suffering, or loss of amenity). Since they are judicially determined, their quantification may vary depending on the circumstances of each case.

Basis of Distinction

The primary distinction between liquidated and unliquidated damages lies in how and when the amount of compensation is determined, and in what context it arises. The following points summarise the key differences:

Basis of Difference Liquidated Damages Unliquidated Damages
Meaning A fixed or pre-estimated amount agreed by the parties at the time of contract formation. Compensation assessed by the court based on actual loss or injury suffered.
Determination Determined in advance by the contracting parties. Determined by the court after the breach or tort has occurred.
Arises In Primarily in breach of contract cases. Commonly in tortious liability and some contractual breaches.
Certainty The amount is certain and predictable. The amount is uncertain until assessed by the court.
Purpose To provide a predetermined remedy and avoid disputes over damages. To ensure fair compensation based on the extent of proven loss.
Judicial Intervention Minimal; courts enforce if the amount is a genuine pre-estimate of loss. Significant; courts evaluate evidence and quantify loss.
Example Delay clause in a construction contract specifying payment of £500 per day of delay. Compensation for injury in a negligence case or loss due to nuisance.

Legal Principles and Judicial Approach

Courts draw a crucial distinction between liquidated damages and penalty clauses. A clause stipulating an amount disproportionate to the likely loss is treated as a penalty and is not enforceable. The intention of the parties and the proportionality of the amount play decisive roles in judicial interpretation.
In Cavendish Square Holding BV v Talal El Makdessi (2015) and ParkingEye Ltd v Beavis (2015), the UK Supreme Court reaffirmed that the test for enforceability is whether the clause protects a legitimate business interest and is proportionate to that interest. This marked a modern approach beyond the traditional penalty rule, focusing on commercial justification rather than strict mathematical precision.
For unliquidated damages, the court exercises wide discretion in quantifying compensation. In H. Parsons (Livestock) Ltd. v Uttley Ingham & Co. Ltd. (1978), it was held that damages must be foreseeable and not too remote. Similarly, in The Wagon Mound (No. 1) (1961), the Privy Council established that damages are recoverable only if the kind of damage was reasonably foreseeable.

Types of Unliquidated Damages

Unliquidated damages can take several forms, reflecting the different aspects of harm suffered:

  • General Damages: Awarded for non-measurable losses such as pain, suffering, or loss of reputation.
  • Special Damages: Cover quantifiable monetary losses like medical bills, repair costs, or loss of earnings.
  • Aggravated Damages: Granted when the defendant’s conduct has been particularly offensive or insulting.
  • Exemplary (Punitive) Damages: Imposed to punish and deter egregious conduct, though rarely awarded in English law.

Practical and Legal Significance

The distinction between liquidated and unliquidated damages has several practical implications:

  1. Predictability and Risk Management: Liquidated damages provide commercial certainty and help avoid litigation over quantum.
  2. Judicial Discretion: Unliquidated damages allow flexibility, enabling courts to deliver justice tailored to the specific harm suffered.
  3. Enforceability: Liquidated damages must satisfy the test of reasonableness and proportionality to be enforceable; otherwise, they are struck down as penalties.
  4. Nature of Remedy: Liquidated damages are contractual in nature, while unliquidated damages are often tortious or equitable.
  5. Mitigation Requirement: In both types, the claimant must take reasonable steps to mitigate their loss.
Originally written on April 13, 2013 and last modified on October 17, 2025.

1 Comment

  1. Aasha

    November 9, 2017 at 9:13 pm

    Didn’t get the answer….

    Reply

Leave a Reply

Your email address will not be published. Required fields are marked *
